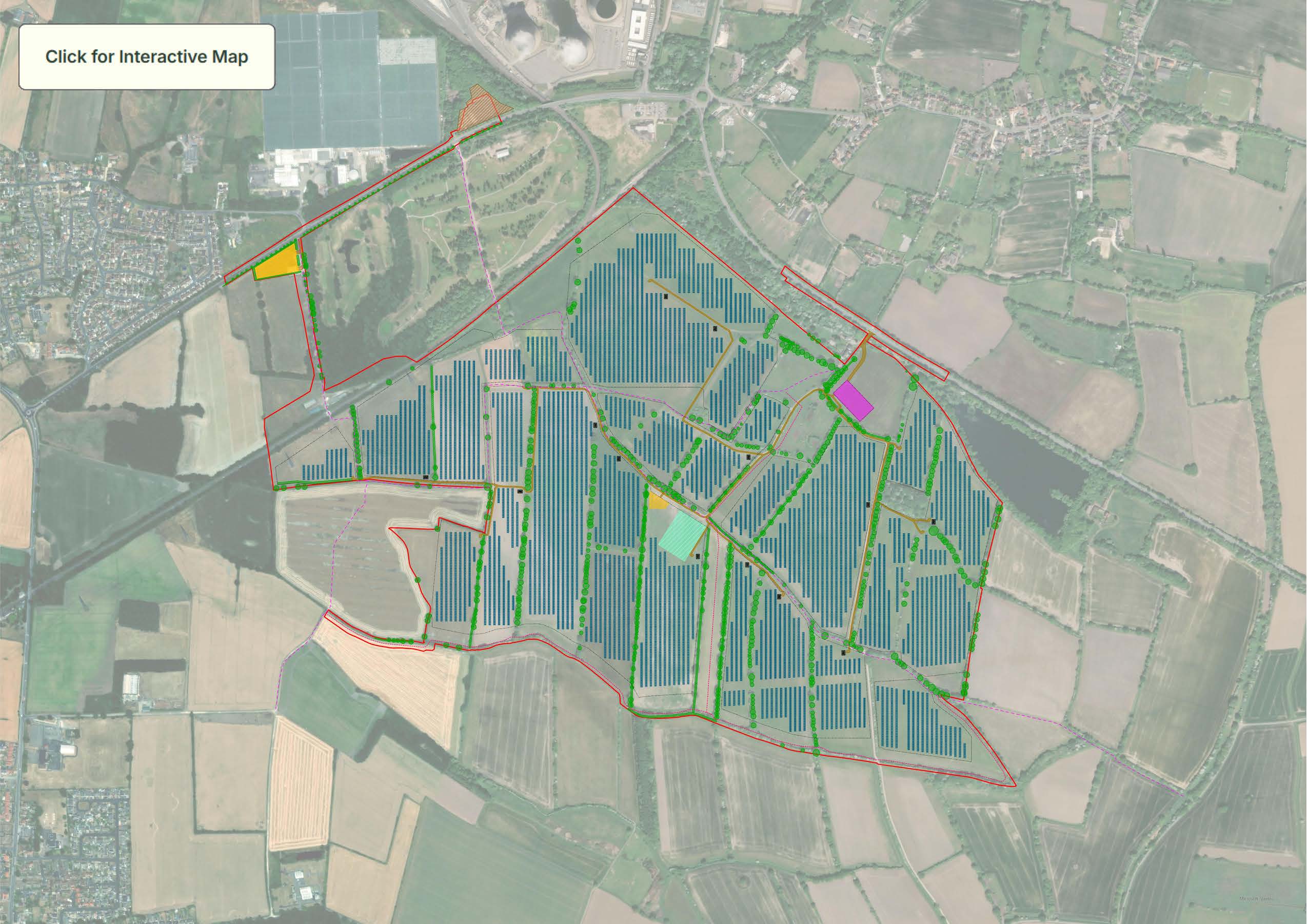

Carlton Solar Farm

Carlton Solar Farm is a consented 49.9MW solar photovoltaic (PV) project located near Carlton, North Yorkshire.

This website will be updated during construction and should be used for project updates, notices and feedback. Subscribe below to be updated on construction progress, and if there are any comments or concerns you wish to raise please use the feedback form at the bottom of this page.
Latest Updates
Subscribe below to receive our latest newsletters and project updates. Be the first to hear about key milestones, upcoming works, and important developments as the project moves through the construction process. Alternative formats, including large print or telephone updates, are available on request.
Thank you! Your submission has been received!
Oops! Something went wrong while submitting the form.

The Development

The development covers approximately 166 hectares and has consent for a 40-year operational period. At the end of this period, the land will be returned to agricultural use.

The project has been designed to make efficient use of the available grid connection in the area while responding to local environmental, landscape, heritage, ecological, drainage and highway considerations assessed through the planning process.

The scheme includes solar panels and batteries, electrical equipment, internal access tracks, underground cabling, landscaping, ecological enhancement areas and a connection to the local electricity network via the substation at Camblesforth.

The project includes measures to mitigate landscape and ecological impacts, alongside enhancements to support biodiversity and environmental quality, secured through the planning permission. Landscaping will be undertaken during the appropriate planting seasons as the project is finalised.
49.9
MW
of power generation
23,900
homes powered per year
17,609
tonnes of CO2 displacement per year

Project Milestones

Our preferred principal contractors for the project have now been selected and enabling works are soon to commence. The project's general timeline is below:

2022-2023

Consultation and Design

Public consultation undertaken and feedback inputted into the design.

February 2023

Planning Submitted

Planning application submitted to the local planning authority.

April 2024

Planning Approved

Link to planning documents*

2023/0128/EIAZG2025/0678/S73

October 2025

Enray Power Acquire Project

October 2025 - May 2026

Construction Pending - Final Approvals

Planning permission granted. Detailed design, discharge of conditions and contractor appointed.

June 2026 - Present

In Construction

Project enters construction period.

February 2028

Operational

Project energised and operating.

As part of our commitment to the community we will be updating this website where changes in programme occur. We will work closely with the local Parish Council and North Yorkshire Council to reduce inconvenience to the public.

Should you have any questions or concerns the please contact the project team via the feedback form.

A Managed Construction Process

June 2026

Site preparation.

June 2026

Construction begins, with the project team mobilising and establishing site facilities and access arrangements.

June - July 2026

Enabling works.

June - July 2026

Early works to prepare the site, including access improvements, fencing, drainage and environmental protection measures.

July 2026

Civil works commence.

July 2026

Construction of access tracks, foundations, drainage and other supporting infrastructure.

September 2026 - June 2027

Mechanical works.

September 2026 - June 2027

Installation of mounting structures, inverter stations and associated equipment. Piling works take place between September 2026 - December 2026.

September 2026 - January 2027

PV module deliveries.

September 2026 - January 2027

Solar panels are delivered to site in phases and installed as construction progresses.

October 2027 - February 2028

Energisation, testing & commissioning.

October 2027 - February 2028

Testing and commissioning of the solar farm prior to operation.
